Portfolio

Powering the future of AI through strategic energy infrastructure investments

7
Sites
9.87 GW
Total Power
8,396
Acres
4,800 MW
From the Grid
5,070 MW
Behind the Meter
Background Pattern

Project Locations

Our strategic portfolio spans across Texas, positioning us at the heart of energy infrastructure development

Lytton Springs
Phase 1 • 850 MW
Click to view details
Mesones
Phase 1 • 420 MW
Click to view details
Cactus Rose
Phase 1 • 400 MW
Click to view details
Site 4
Phase 2 • 2,100 MW
Click to view details
Site 5
Phase 2 • 3,500 MW
Click to view details
Site 6
Phase 3 • 1,500 MW
Click to view details
Site 7
Phase 3 • 1,100 MW
Click to view details
Project Phases
Phase 1 - Fully Permitted
Phase 2 - Permitting
Phase 3 - Due Diligence

Project Sites

Phase 1 - Fully Permitted
  • Lytton Springs

    Caldwell County

  • Mesones

    Williamson County

  • Cactus Rose

    Williamson County

Phase 2 - Permitting
  • Site 4
  • Site 5
Phase 3 - Due Diligence
  • Site 6
  • Site 7
Quick Jump

Project Details

Click on any project card to view detailed specifications and technical information

Phase 1 - Fully Permitted Sites

1,670 MW Total

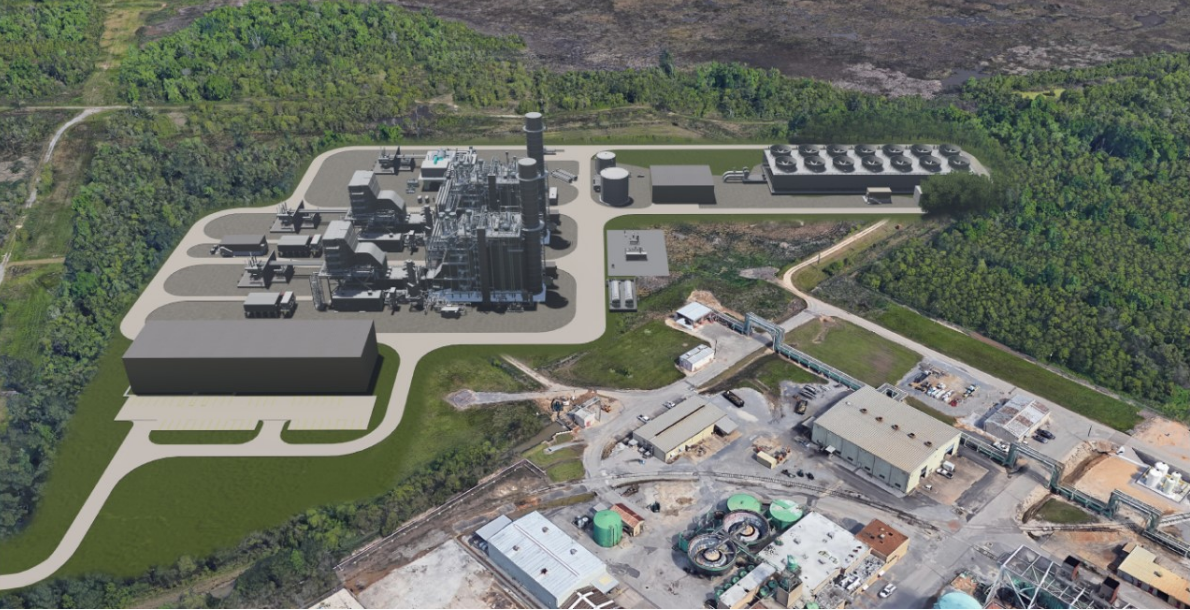

Lytton Springs energy project site

Lytton Springs

Caldwell County, Texas

Phase 1 - Fully Permitted
262
Acres
400
Grid MW
450
CCGT MW
Click to view details
Interconnection Status
LCRA/ Blue Bonnet Co-Op - DSA Pending
CCGT Commissioning
12-14 Months
CCGT Model
Siemens V98
Natural Gas Contracts
Kinder Morgan / Energy Transfer
Total Power Capacity850 MW

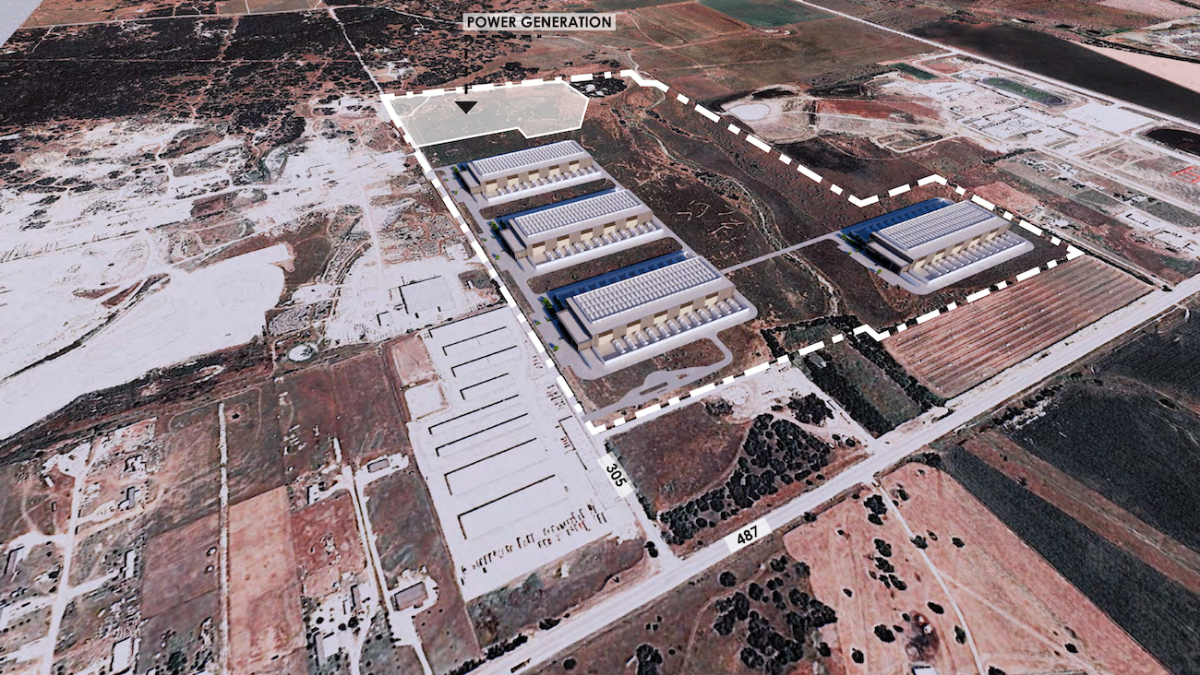

Mesones energy project site

Mesones

Williamson County, Texas

Phase 1 - Fully Permitted
151
Acres
200
Grid MW
220
CCGT MW
Click to view details
Interconnection Status
Oncor - IFEA signed
CCGT Commissioning
12-14 months
CCGT Model
6X GE LM2500 GTs
Natural Gas Contracts
Whitewater / One Gas
Total Power Capacity420 MW

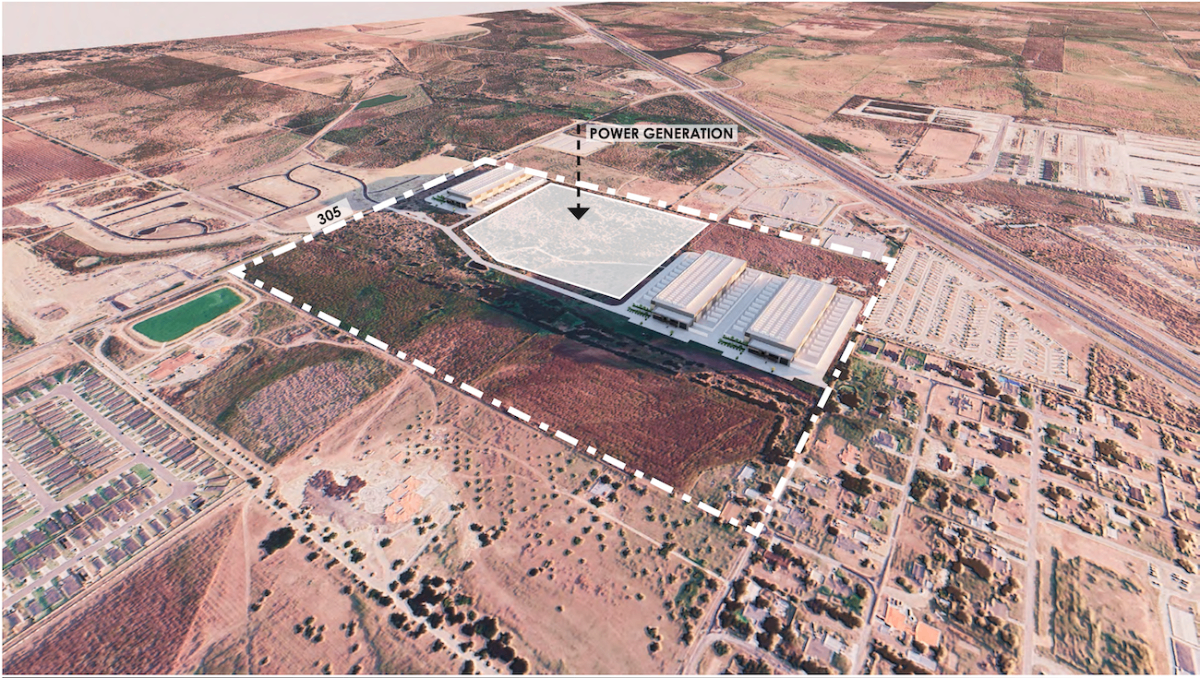

Cactus Rose energy project site

Cactus Rose

Williamson County, Texas

Phase 1 - Fully Permitted
133
Acres
200
Grid MW
200
CCGT MW
Click to view details
Interconnection Status
Oncor - IFEA signed
CCGT Commissioning
12-14 Months
CCGT Model
4X GE LM2500 G5s
Natural Gas Contracts
Whitewater / One Gas
Total Power Capacity400 MW

Phase 2 - Permitting in Process

5,600 MW Total
Site 4 energy project site

Site 4

Phase 2 - Permitting
1,850
Acres
1,000
Grid MW
1,100
CCGT MW
Click to view details
Interconnection Status
Oncor 2027 - 2028
CCGT Commissioning
15-18 months
CCGT Model
GE Frame 9
Total Power Capacity2,100 MW
Site 5 energy project site

Site 5

Phase 2 - Permitting
2,500
Acres
1,000
Grid MW
2,500
CCGT MW
Click to view details
Interconnection Status
AEP in review
CCGT Commissioning
15-18 months
CCGT Model
GE Frame 9
Total Power Capacity3,500 MW

Phase 3 - Due Diligence in Process

2,600 MW Total
Site 6 energy project site

Site 6

Phase 3 - Due Diligence
1,000
Acres
1,000
Grid MW
500
CCGT MW
Click to view details
Interconnection Status
3-4 years AEP new 365kV line
CCGT Commissioning
12-14 months
Total Power Capacity1,500 MW
Site 7 energy project site

Site 7

Phase 3 - Due Diligence
2,500
Acres
1,000
Grid MW
100
CCGT MW
Click to view details
Interconnection Status
Oncor 2028 - 2029
CCGT Commissioning
10-12 months
Total Power Capacity1,100 MW

Portfolio Analytics

Visual breakdown of our energy infrastructure capacity and distribution

Capacity Distribution by Development Phase

9.87
GW Total
Phase 1 - Fully Permitted
1,670 MW
16.9% of total capacity
3 projects ready for development
Phase 2 - Permitting
5,600 MW
56.7% of total capacity
2 projects in permitting process
Phase 3 - Due Diligence
2,600 MW
26.3% of total capacity
2 projects under evaluation

Portfolio Summary

Click column headers to sort • Click phase headers to expand/collapse

Project
Location
Grid MW
CCGT MW
Total MW
Status
Phase 1 - Fully Permitted Sites
1,670 MW Total
Lytton SpringsCaldwell County, Texas400450850LCRA/ Blue Bonnet Co-Op - DSA Pending
MesonesWilliamson County, Texas200220420Oncor - IFEA signed
Cactus RoseWilliamson County, Texas200200400Oncor - IFEA signed
SUB TOTAL8008701,670
Phase 2 - Permitting in Process
5,600 MW Total
Site 41,0001,1002,100Oncor 2027 - 2028
Site 51,0002,5003,500AEP in review
SUB TOTAL2,0003,6005,600
Phase 3 - Due Diligence in Process
2,600 MW Total
Site 61,0005001,5003-4 years AEP new 365kV line
Site 71,0001001,100Oncor 2028 - 2029
SUB TOTAL2,0006002,600
TOTAL4,8005,0709,870
Click rows to jump to project details
Click headers to sort columns
Click phase headers to expand/collapse
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Sorry, we have no imagery here.
Texas
Google
Map data ©2026 Google, INEGI
Map data ©2026 Google, INEGI
